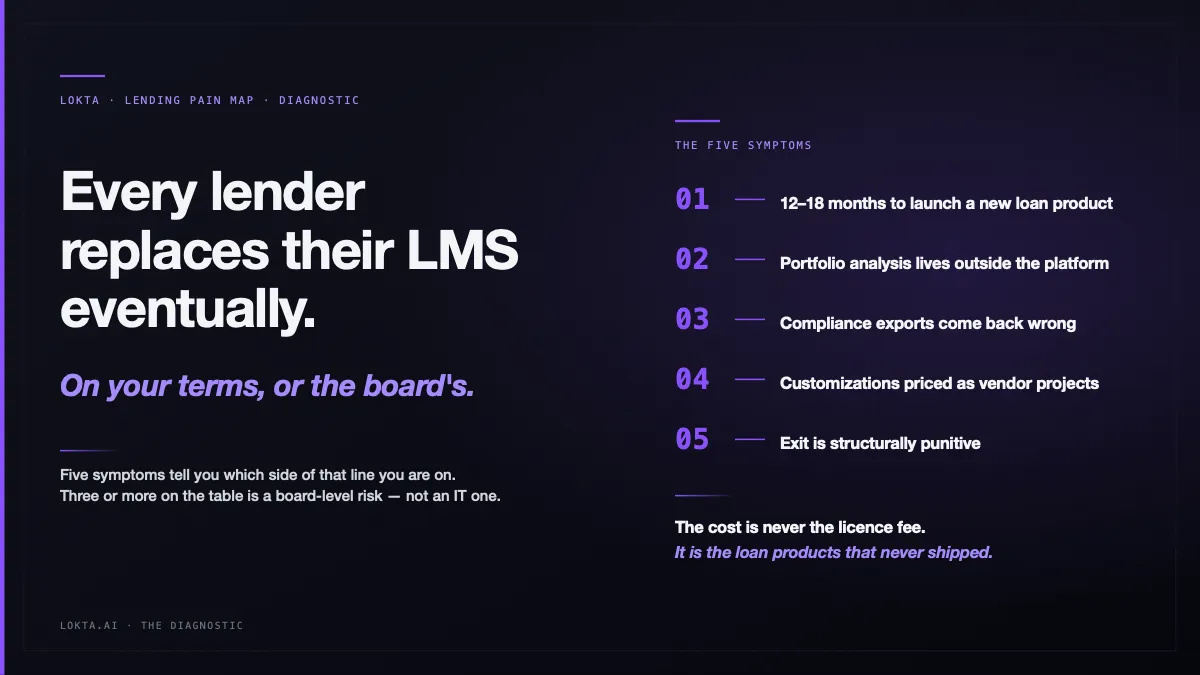

Before you renew your LMS, assess these five symptoms
Start an LMS renewal assessment two quarters ahead. Review five operating symptoms, contract notice dates and parallel-run evidence before choosing to stay or move.

Contents 10 sections
A lender should assess its loan management system before the renewal quote becomes the deadline for deciding. The useful question is whether the current arrangement still supports the book, at an acceptable cost and risk, and whether there is a practical alternative.
A higher renewal price is a reason to examine the choice. It does not establish that replacement is the right answer. Start with five symptoms, using evidence from your own operation rather than a vendor’s account of what is wrong with legacy systems.
1. Routine product changes keep waiting for the vendor
Take a recent post-approval change: a repayment schedule variant, charge rule or servicing configuration. Record the request date, approval, vendor queue, implementation, testing and release. Separate working time from waiting time.
If a routine change repeatedly becomes a project, establish why. The cause might be the platform’s architecture, a contract boundary, unavailable lender staff or unclear requirements. Ask which constraints can be removed under the current arrangement and which would remain. A replacement proposal needs to demonstrate the same change, including its effect on existing loans.
2. Portfolio analysis cannot be traced to the book
An export is not automatically a control failure. The question is whether a reviewer can trace an important portfolio measure to the account history, cut-off and calculation that produced it.
When a board report relies on adjustments only one person can explain, document those steps and their owners. The portfolio analytics guide examines why reporting ends up outside the loan platform. Use that analysis to distinguish a reporting process that needs repair from a system that cannot supply the necessary evidence.
3. Compliance exports need repeated manual repair
Keep examples of rejected, incomplete or inconsistent outputs and the work required to correct them. Name the affected requirement and the source record that disagreed with the export. Distinguish data-quality errors, an incorrect configuration and an unsupported report.
The lender should be able to reproduce the corrected result and show who accepted it. A vendor’s promise to fix a format needs an owner, acceptance criteria and an agreed release path. Assess whether a replacement actually removes the failure or merely moves the same manual reconstruction to another team.
4. Every change becomes a separate commercial project
Review change invoices alongside the requests that generated them. Separate ordinary configuration, bespoke development, integration changes and regulatory updates. A high services bill needs context: what was agreed, what changed and who accepted the work.
The LMS customization trap covers the commercial dependency. For this assessment, price both the supplier work and the lender’s specification, testing and release effort. Use the LMS cost model to compare the full operating cost of staying and moving on the same scope.
5. Exit terms leave no practical alternative
Read the notice clause before the renewal discussion. Record the renewal date, the deadline and method for giving notice, minimum commitments, export obligations, transition assistance and any termination charge. Have legal counsel interpret the actual agreement; an assumed notice period is not a plan.
Then test the operational side. Can another team understand an export of the loan history, reproduce balances and identify unresolved items? Who will provide access during transition? A strategic-liability LMS is a useful description of a constraint, not a score that replaces this evidence.
For covered NBFC material IT-outsourcing arrangements, the RBI’s Managing Risks in Outsourcing Directions, 2025, paragraphs 83-88, address continuity, alternative arrangements, data handling and transition cooperation. Applicability depends on the entity, layer and arrangement under paragraphs 3 and 5. The deployment and exit guide develops that review.
Start the assessment and parallel-run work two quarters before renewal
Two quarters before renewal is a useful starting point for the assessment and the work needed to run a parallel comparison. Start earlier if the notice window, book complexity or implementation scope requires it. This is an operating recommendation, not a six-month delivery promise or an RBI deadline.
Put the renewal and non-renewal notice dates on the same plan. The notice date may force a commercial decision before the renewal date itself. Work backwards from the earlier commitment, including time for the lender’s procurement, risk, legal and board processes.
| Planning point | Work to complete | Decision evidence |
|---|---|---|
| Two quarters before renewal, or earlier | Review the contract and five symptoms; request renewal terms; assess export quality; scope the parallel run | Dates, options, owners, acceptance criteria and budget |
| While options are evaluated | Test representative account histories and interfaces; start the parallel run once prerequisites are ready | Reconciled results, exception ownership and a realistic remaining plan |
| Before the notice or renewal commitment | Compare staying, remediation and replacement; review unresolved risks and any bridge arrangement | A recorded commercial decision with conditions |
| Before cutover | Complete acceptance and approve the transition and fallback arrangements | Named go/no-go decision based on evidence |
Budget for overlap: two systems, reconciliation effort, training, export support and any retained access to history. Keep one authoritative path for postings and borrower contact while the other system is being compared. Parallel testing must not create duplicate financial transactions or collection messages.
The migration cutover guide recommends a parallel run covering at least a full billing cycle and explains what needs to reconcile. Use the implementation timeline guide to work through scope and dependencies. Neither turns the renewal date into proof that the new system is ready.
If breaks remain unresolved, bring them to the decision owner with the cost of extending the current arrangement and the risk of proceeding. A short bridge, where it can be agreed, may cost less than a rushed switch. Its availability and price need negotiation; they are not assured.
Choose between renewing, remediating and replacing
Renew when the current arrangement meets the operating need and its forward cost is acceptable. Agree a bounded remediation plan when the gaps have clear owners, testable fixes and commercial terms the lender can accept. Replace when the remaining constraints justify migration cost and the alternative has passed the required evaluation.
All three require work. Replacement adds transition risk; staying leaves any unresolved dependency in place. Put both consequences in the decision record, with a review date and the person accountable for the next step.
Bring the renewal date and one unresolved operating problem to a conversation with Lokta. The first decision is what the evidence supports, including whether to stay.
Read next
- LMS migration and cutover sequence: the detailed reconciliation and transition steps
- Loan management system cost: compare the full cost of the options
- LMS selection mistakes: prepare the evaluation and board decision record
Frequently asked questions
When should a lender assess an LMS replacement before renewal?
Start the assessment and parallel-run planning two quarters before the renewal date, and earlier if notice terms or migration complexity require it. This is a planning recommendation, not a regulatory deadline or a promise that a migration takes six months. Identify the non-renewal notice date first, then work backwards through decision, procurement, data preparation, testing and acceptance. Start the parallel run when its prerequisites are ready, with enough time to resolve breaks before the commercial decision becomes unavoidable.
Does a higher LMS renewal price mean the lender should replace it?
No. Compare the cost of staying with the full cost and operating risk of leaving. The comparison should include the platform fee, paid changes, manual work, migration, integrations, overlapping contracts, training and retained access to history. A price increase may justify an assessment or renegotiation without justifying replacement. Record which operating problems each option resolves and which remain. A lower licence quote is insufficient if the new arrangement leaves the same reconciliation or control problems unresolved.
What makes an LMS problem a board-level concern?
Its consequence for the lender's ability to operate, change and evidence its book. Repeated reporting breaks, unresolved control gaps, expensive dependencies or an unusable exit path can require board attention even if only one is material. There is no validated three-symptom threshold in this article. Put the evidence, exposure, remediation owner and decision needed in front of the appropriate authority. The purpose of the diagnostic is to structure that discussion, not to produce an automatic replacement verdict.
What should be checked in an LMS exit clause?
Check the notice deadline, renewal mechanism, minimum commitments, termination costs, data-export scope and format, retained record access, and the assistance available during transition. Have legal counsel review how those obligations work together in the actual agreement. There is no universal exit-penalty percentage. Test whether the exported history can be interpreted and reconciled by another team. A right to receive a file is only useful if the lender has a workable way to continue operating its book.
Can the renewal date determine when the new LMS goes live?
It can be a planning constraint, but it should not replace acceptance evidence. The old and new systems need to agree on the defined scope, with discrepancies resolved and authorised people signing the cutover decision. Keep one authoritative posting and borrower-contact path during parallel testing so comparison does not duplicate live activity. If the evidence is incomplete near the commercial deadline, assess a bridge arrangement or revised plan instead of assuming that expiry makes the new system ready.
